HULL ASSEMBLY - Hull Openings

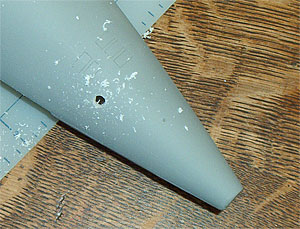

1. With the stern piece completely cured, it is now time to open the many holes necessary to correctly model a Permit class SSN. Using the supplied plans as a reference, locate the dimple in the hull where the mushroom anchor is mounted just forward of the lower rudder. Using an electric drill and a 7/32 bit, drill out the dimple to receive the cast resin mushroom anchor. Use a round file to widen the hole to fit if necessary.

NOTE: Following the curing of the stern pieces, the Permit hull depicted was painted with primer. This allowed the scribed hull opening lines to be more clearly seen during the drilling process. However, it is not required that you prime your hull at this time. Details on how to prime and paint your model will be outlined in section 9 "Detail & Paint".

2. Switch to a 1/8 bit and drill one or two holes in each Main Ballast Tank flood hole. The MBT floods are rectangular in shape and there are 5 grouped just forward of the anchor. These holes will allow the use of a Dremel grinding bit to further clean out the opening.

TIP: Take the time to mark each flood to be opened with a pencil or marker prior to drilling to prevent mistakes.

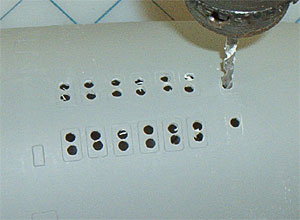

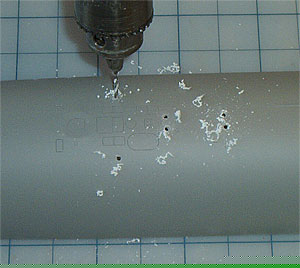

3. Moving forward, locate the next set of floods amidships and drill similar holes in them as well. There are 20 MBT floods in this section.

NOTE: Do not drill in the T-shaped area scribed in between the flood groups. This is the cover for the Secondary Propulsion Motor (SPM) and should be left intact.

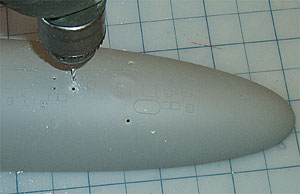

4. Locate the forward group of floods near the sonar dome demarcation line. There are 14 scribed rectangles. Drill pilot holes in each of the floods.
5. With the floods completed, switch to a 7/32 bit and drill pilot holes in the two Main Sea Water openings on either side of the hull. The lower hull opening pilot holes are now complete.

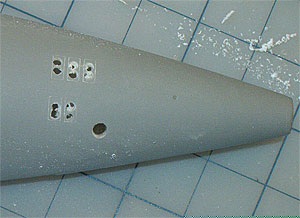

6. On the upper hull you will notice dimples representing the Main Ballast Tank vent openings. A set of stainless steel photo-etched parts will accurately depict the MBT vents and will be installed in a later section. However, holes must be drilled in the hull to allow trapped air to escape through each vent during r/c operations. Using a 3/32 bit, drill a single hole in the center of each of the 6 MBT vent dimples in the forward section.
7. Moving amidships, drill holes in each of these 6 MBT vent dimples.

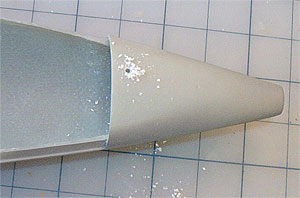

8. Finally, locate and drill the single MBT vent in the upper stern section of the lower hull. It is located slightly forward and to starboard of the upper rudder.

Don't be alarmed. Though your model may look more like Swiss cheese than a submarine at this point, it will soon take on a scale appearance with our next step...



Next





Hull Opening Glossary

Main Ballast Tank (MBT) vent: Round, stainless steel vent valve in the top of main ballast tanks that open to allow air to escape for diving and close to trap air for surfacing.

Main Ballast Tank flood/drain: Rectangular opening in the bottom of main ballast tanks that allow the free flow of water into, and out of, the tank during diving and surfacing.
